Research & Development Process Timeline

  • March 4 2021
  • January 2021

    Update Tour

  • December 2020

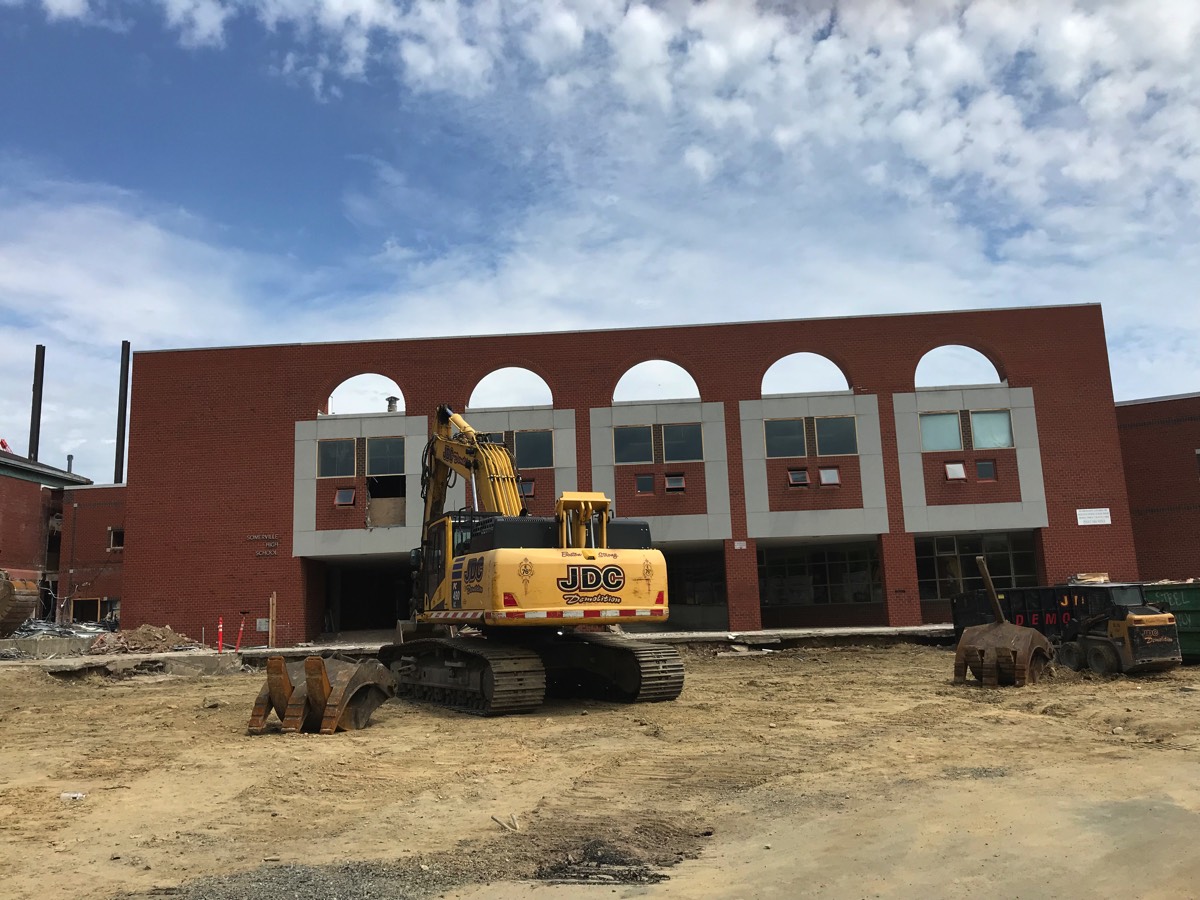

    Phase 3 Begins

  • September 2020

    Update Tour

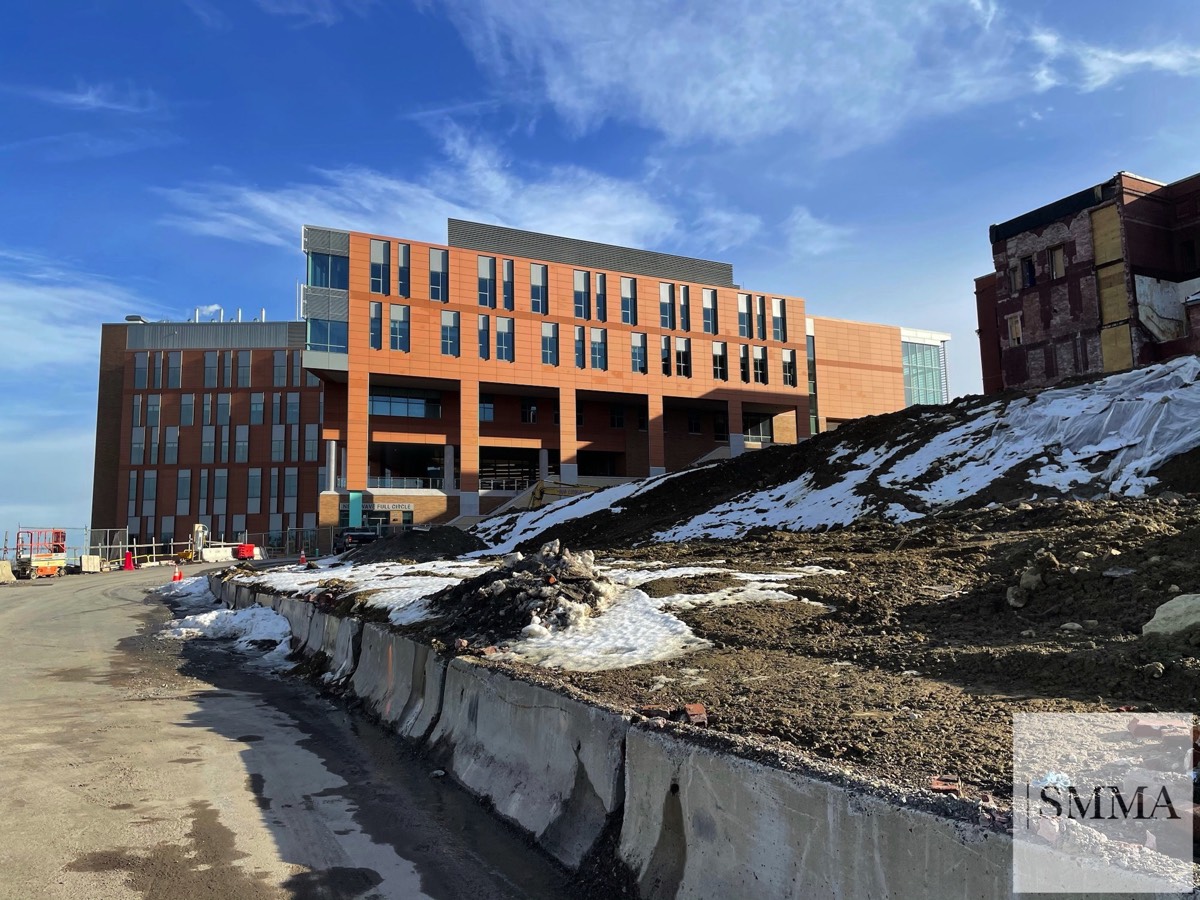

  • May 2020

    Construction Resumes with Additional Safety Protocols

  • March 2020

    Non-Essential Construction Suspended During COVID-19

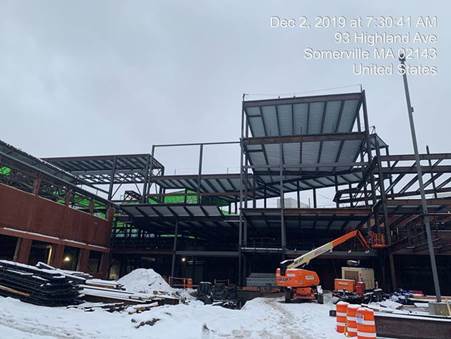

  • December 2019

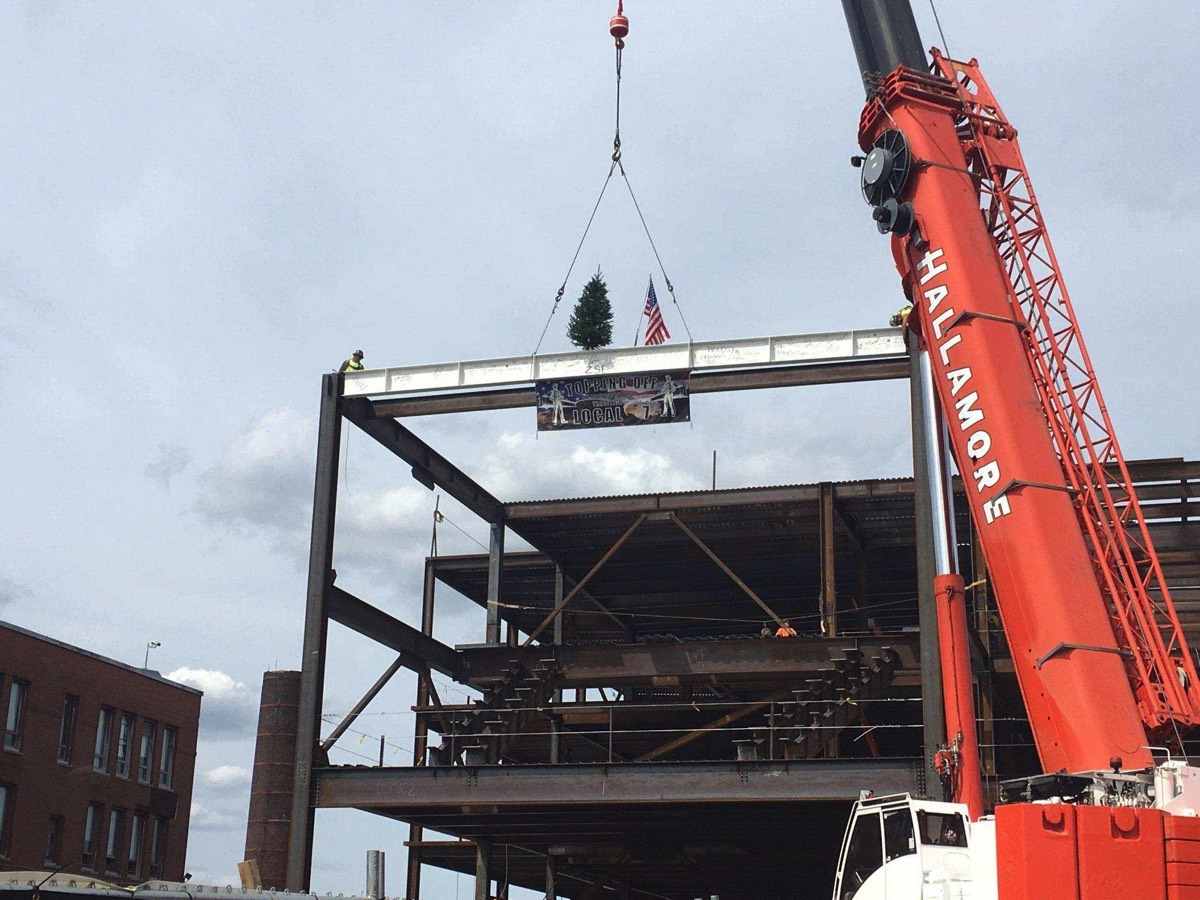

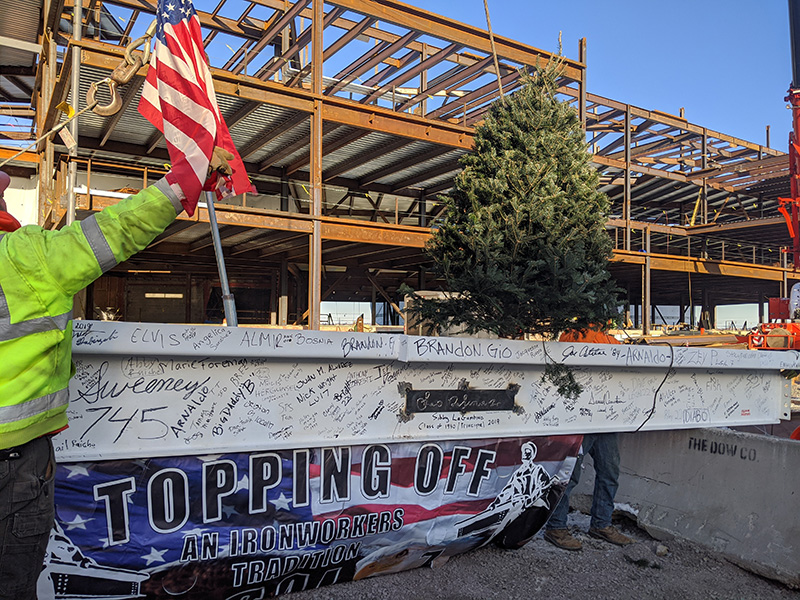

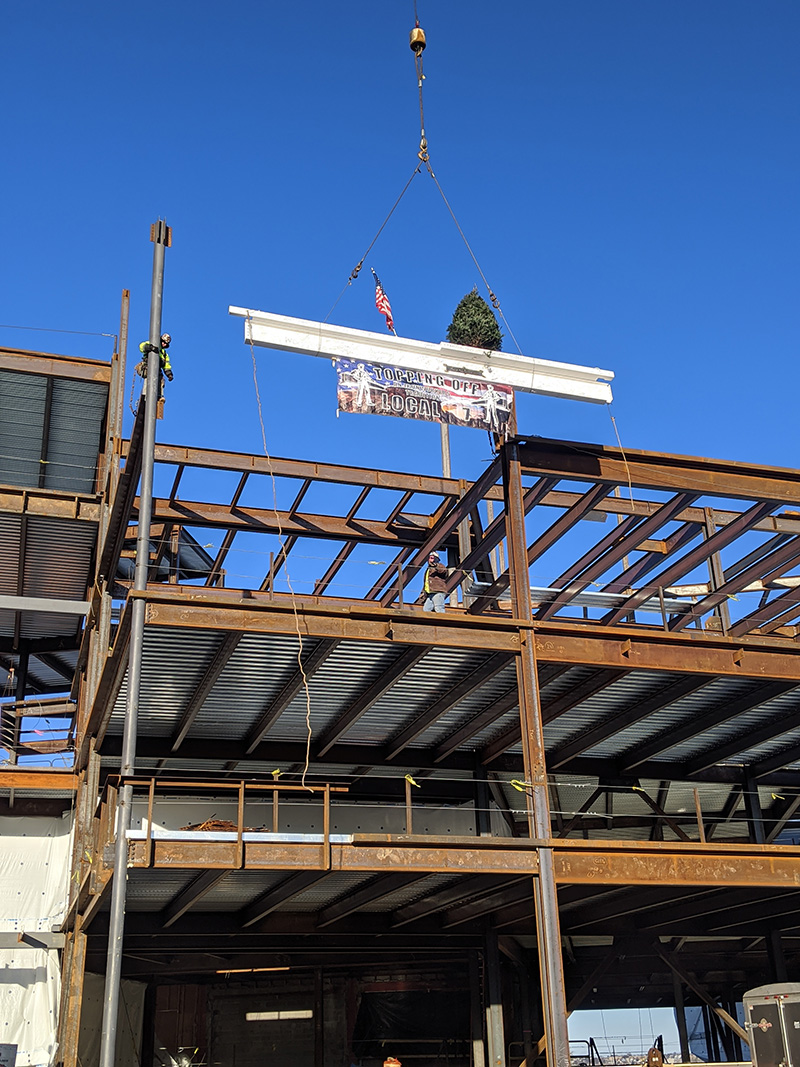

    Phase 2 Topping Off Ceremony

  • November – December 2019

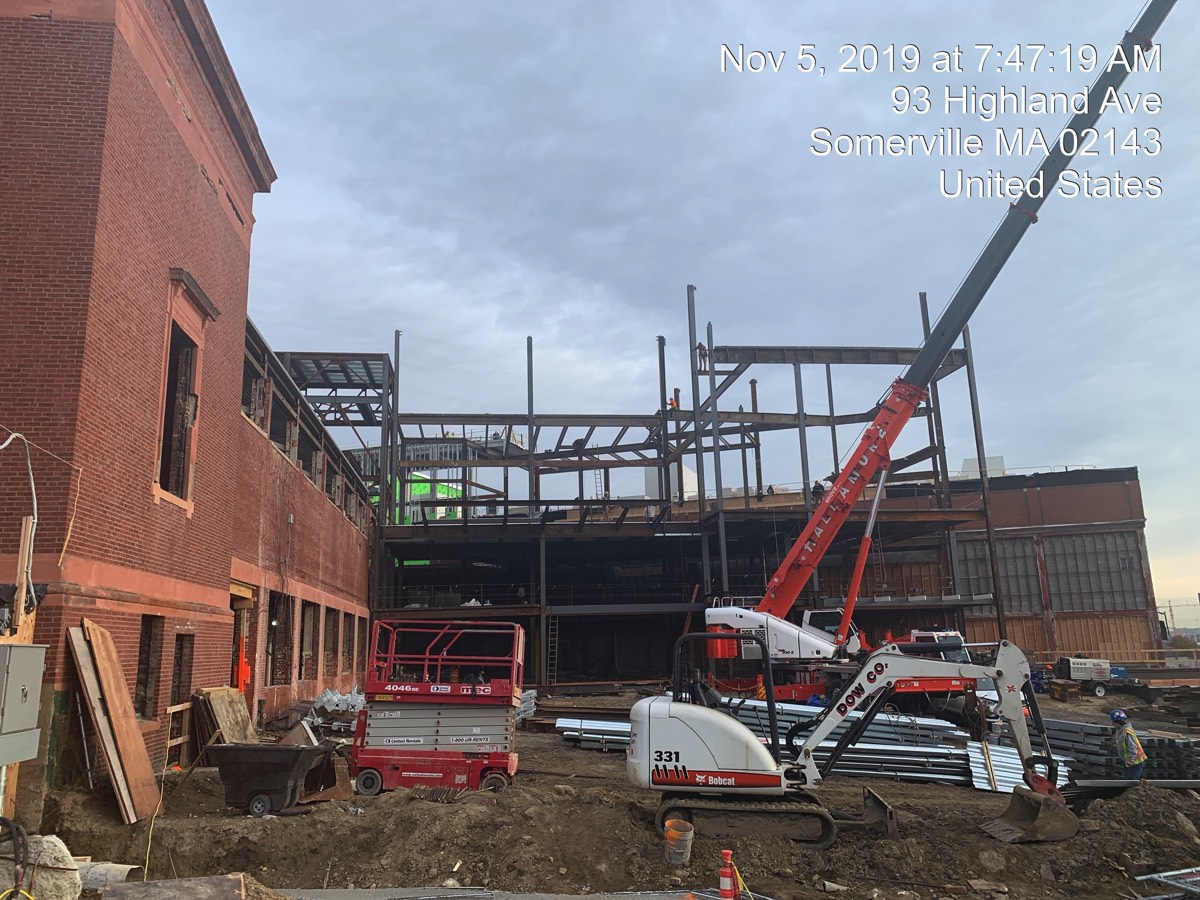

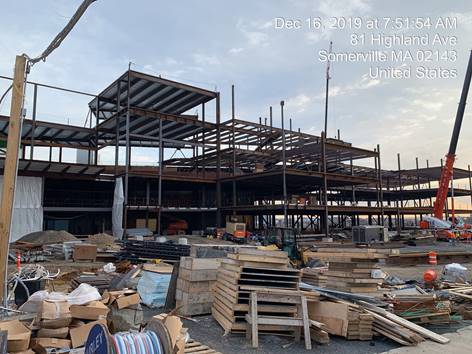

    Phase 2 Steel Progression

  • October 2019

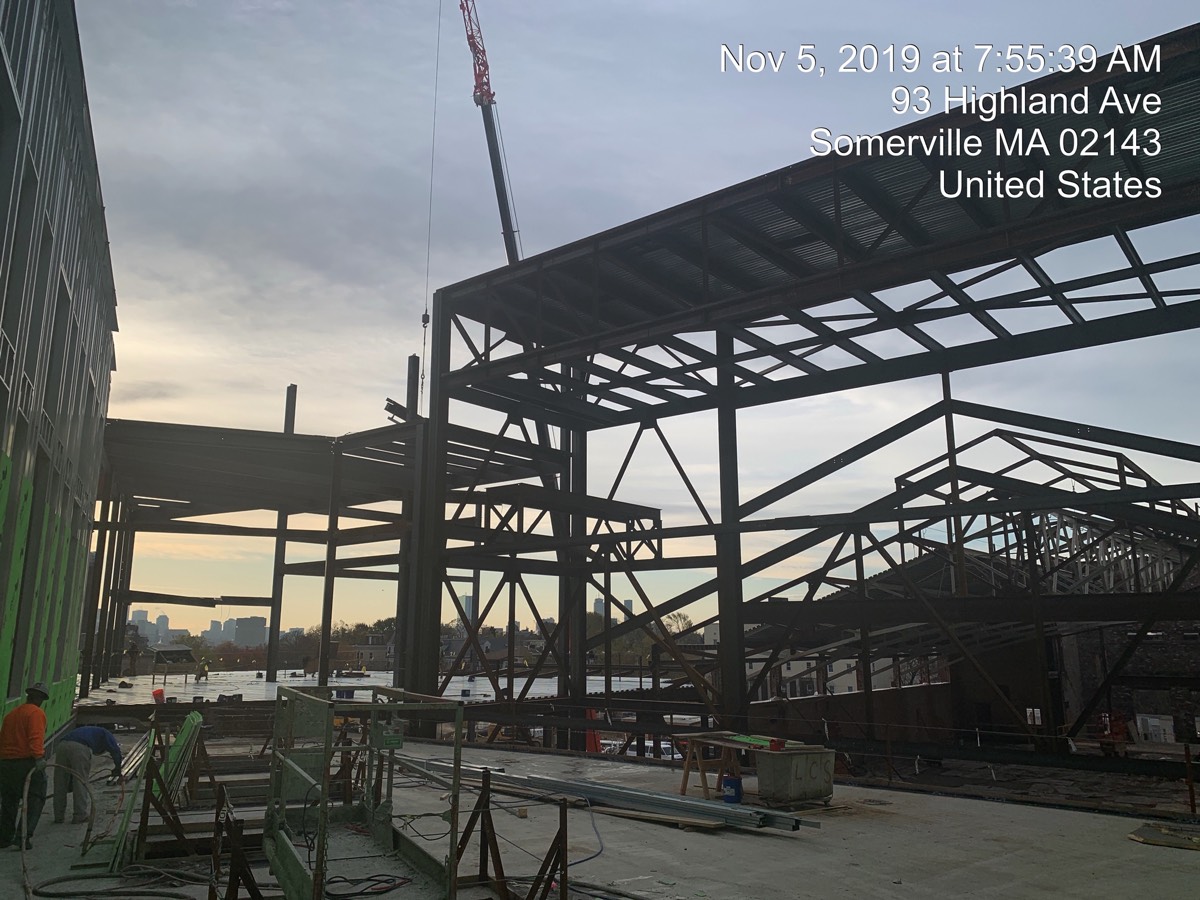

    Phase 2 Steel Installation Begins

  • August 2019

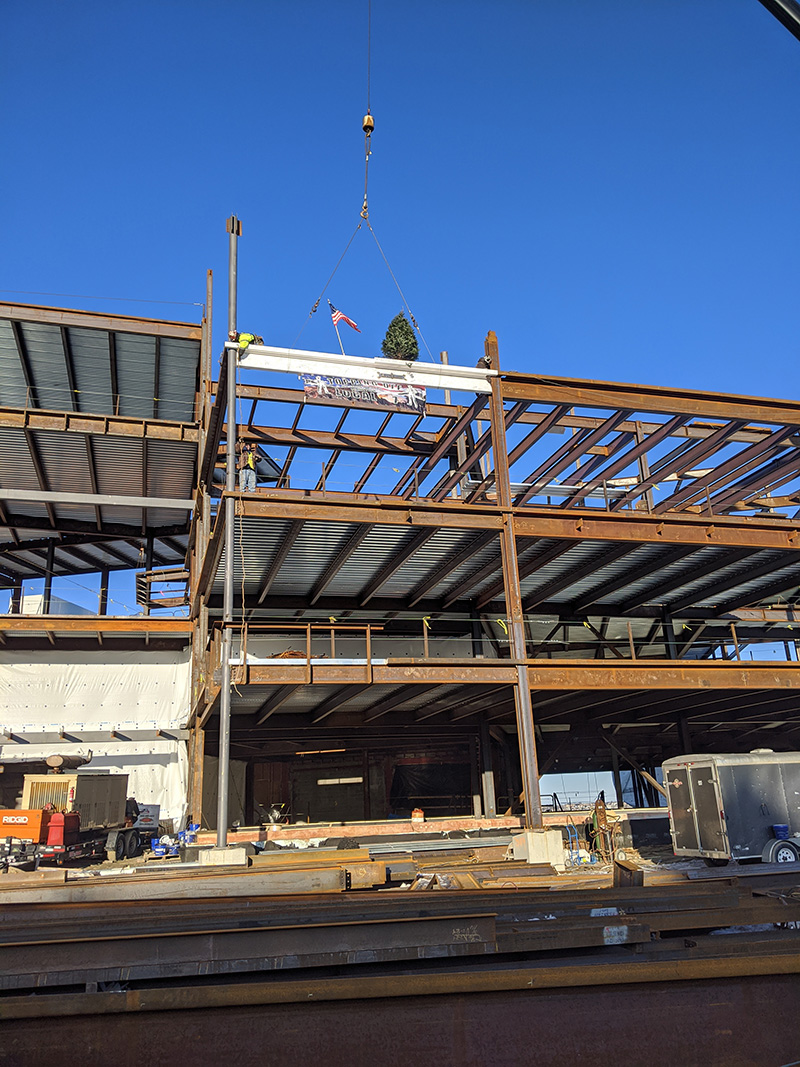

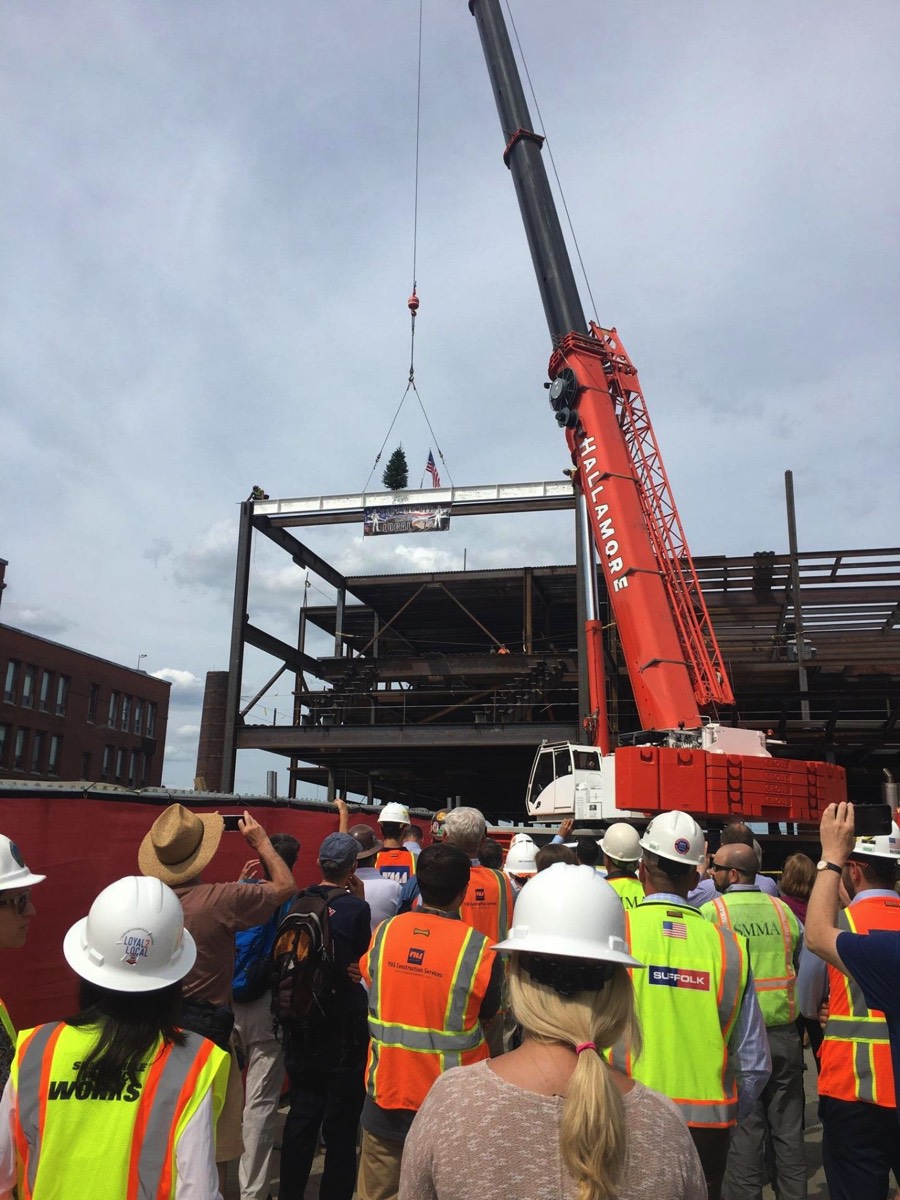

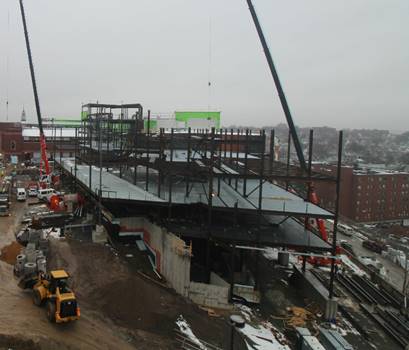

    Phase 1 Steel Topping Off Ceremony

  • July 2019

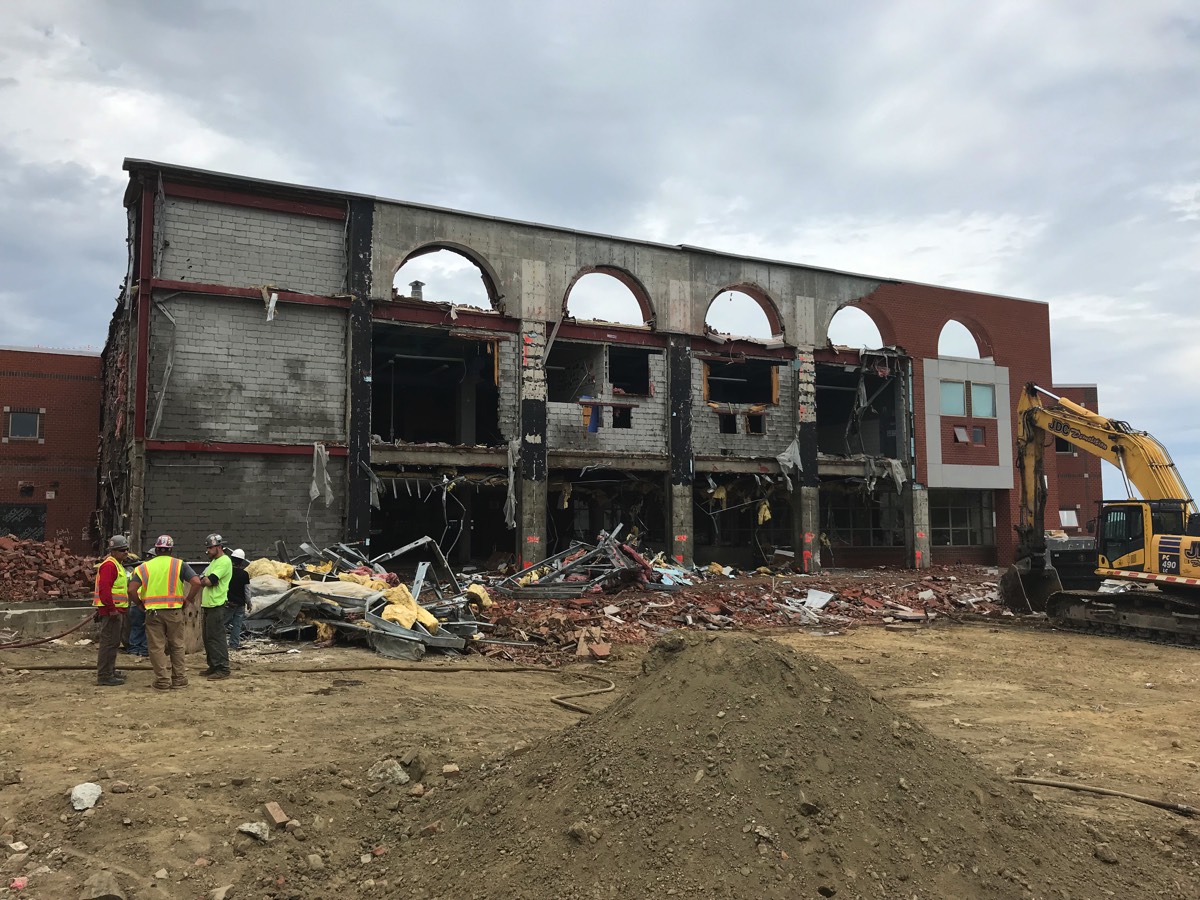

    E Building Demolition

  • June 2019

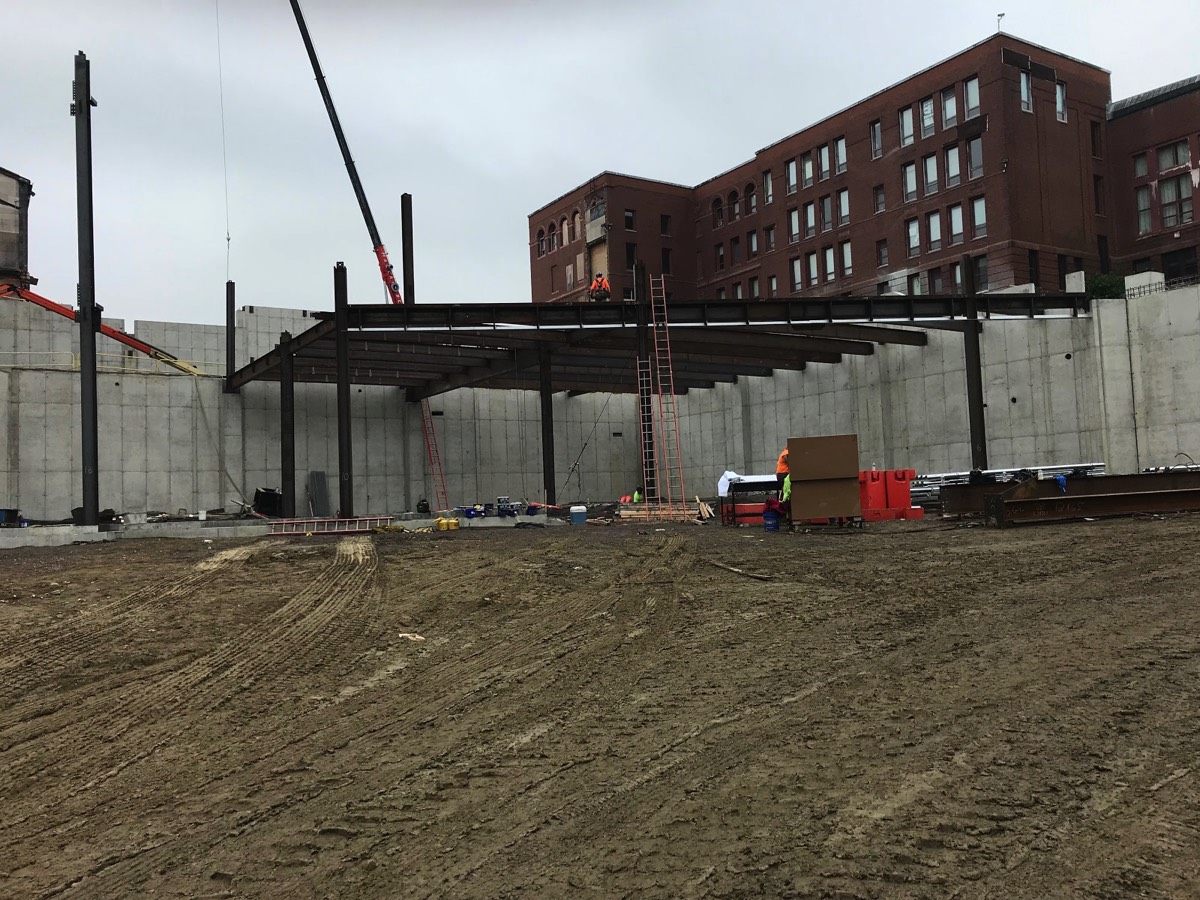

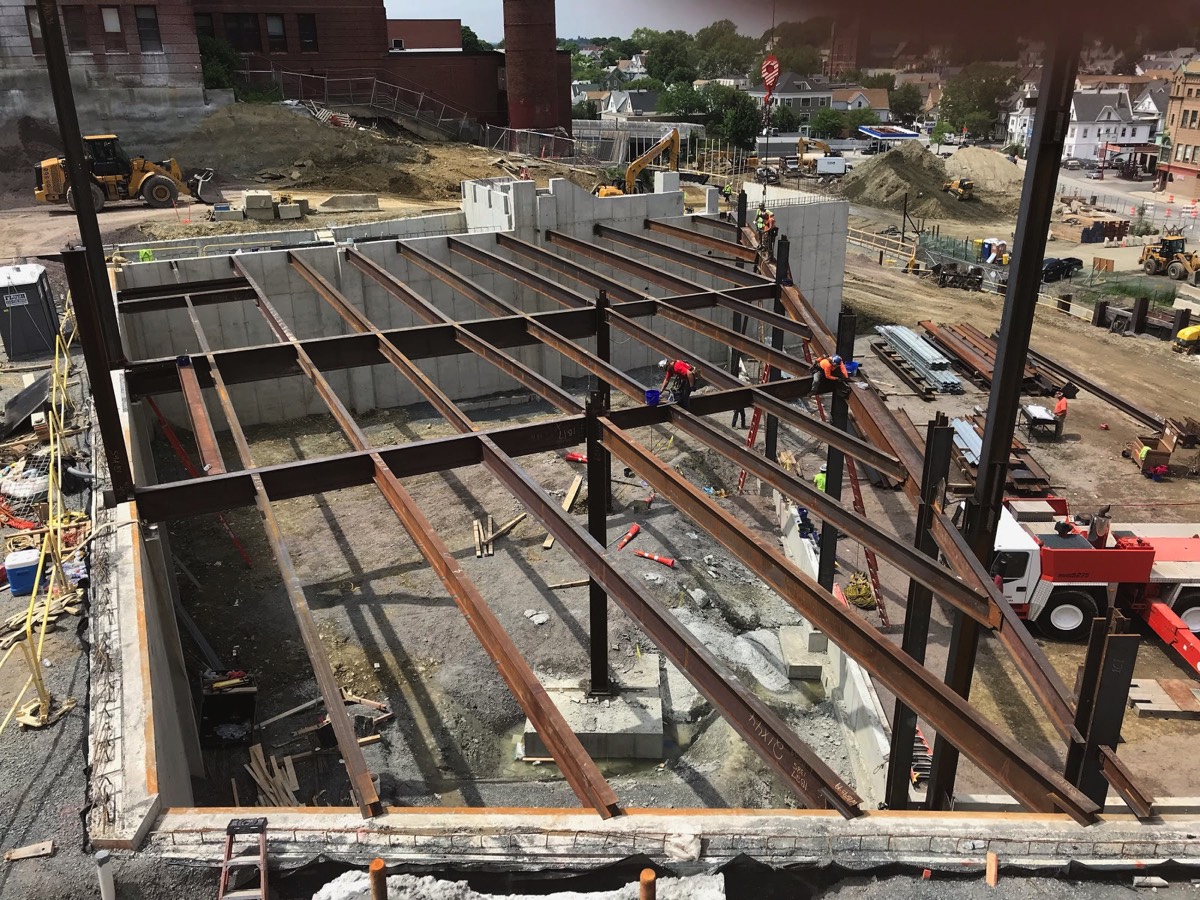

    Phase 1 Structural Steel Installation

    Click on an image to enlarge it:

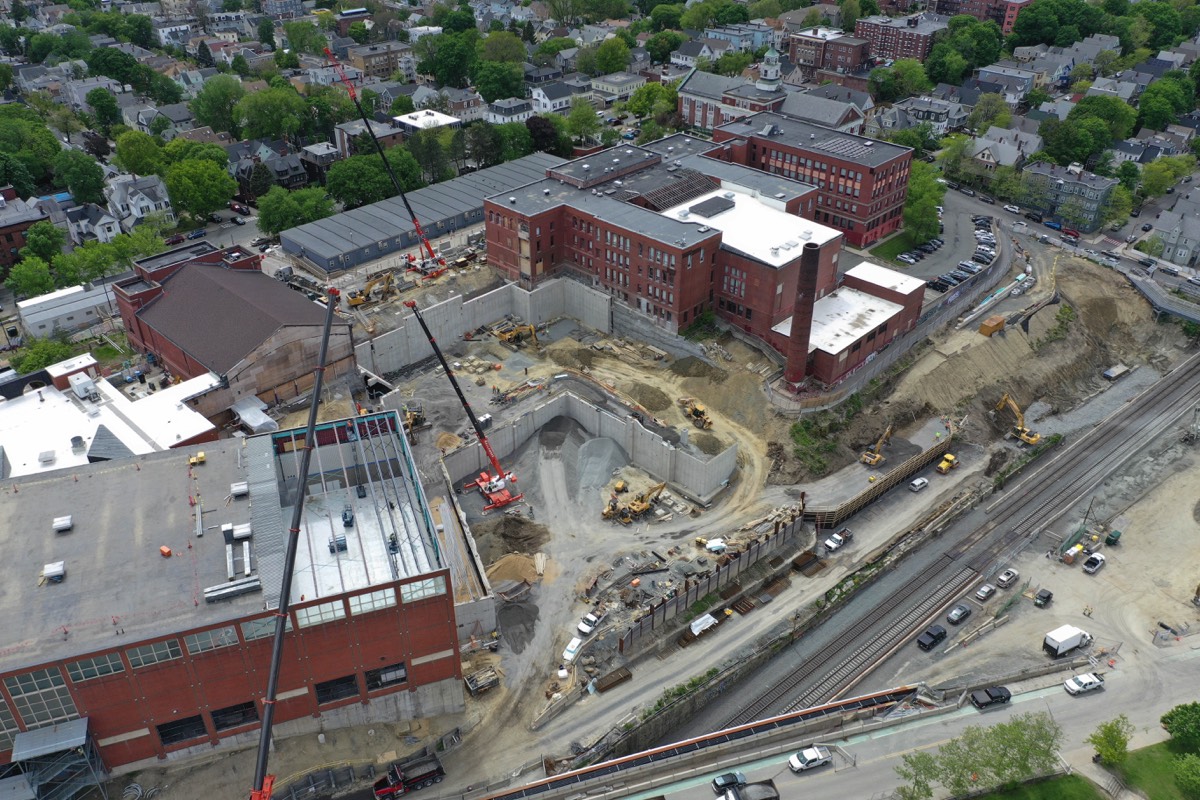

  • May 2019

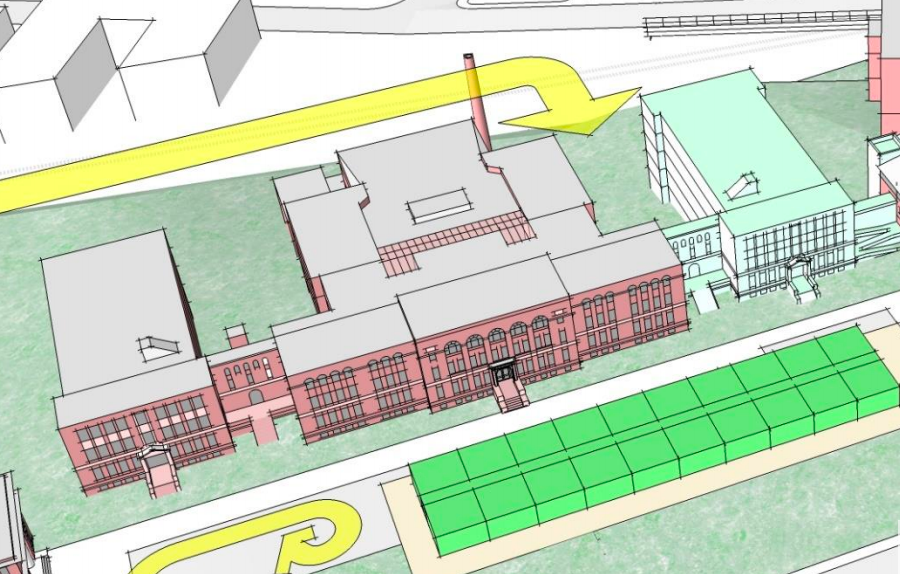

    Gym Roof Reconstruction

    Click on an image to enlarge it:

  • March 2019

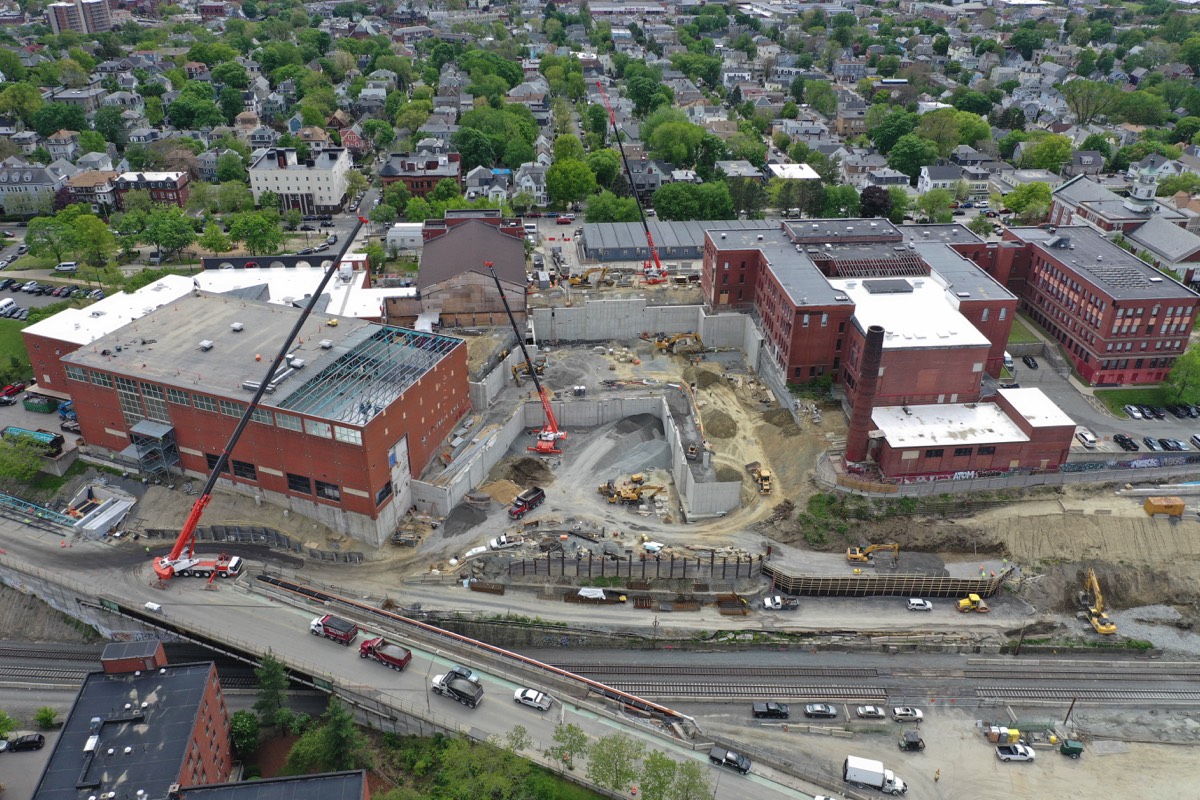

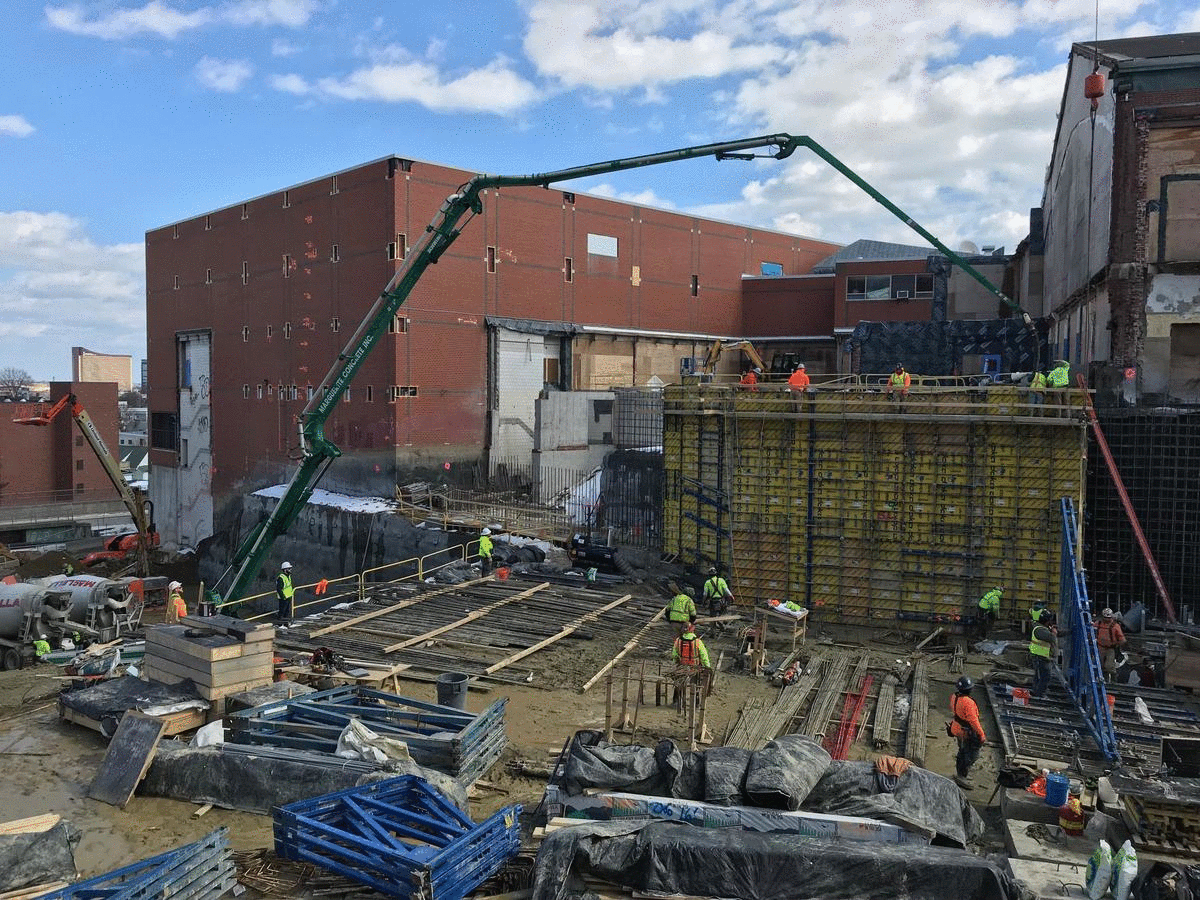

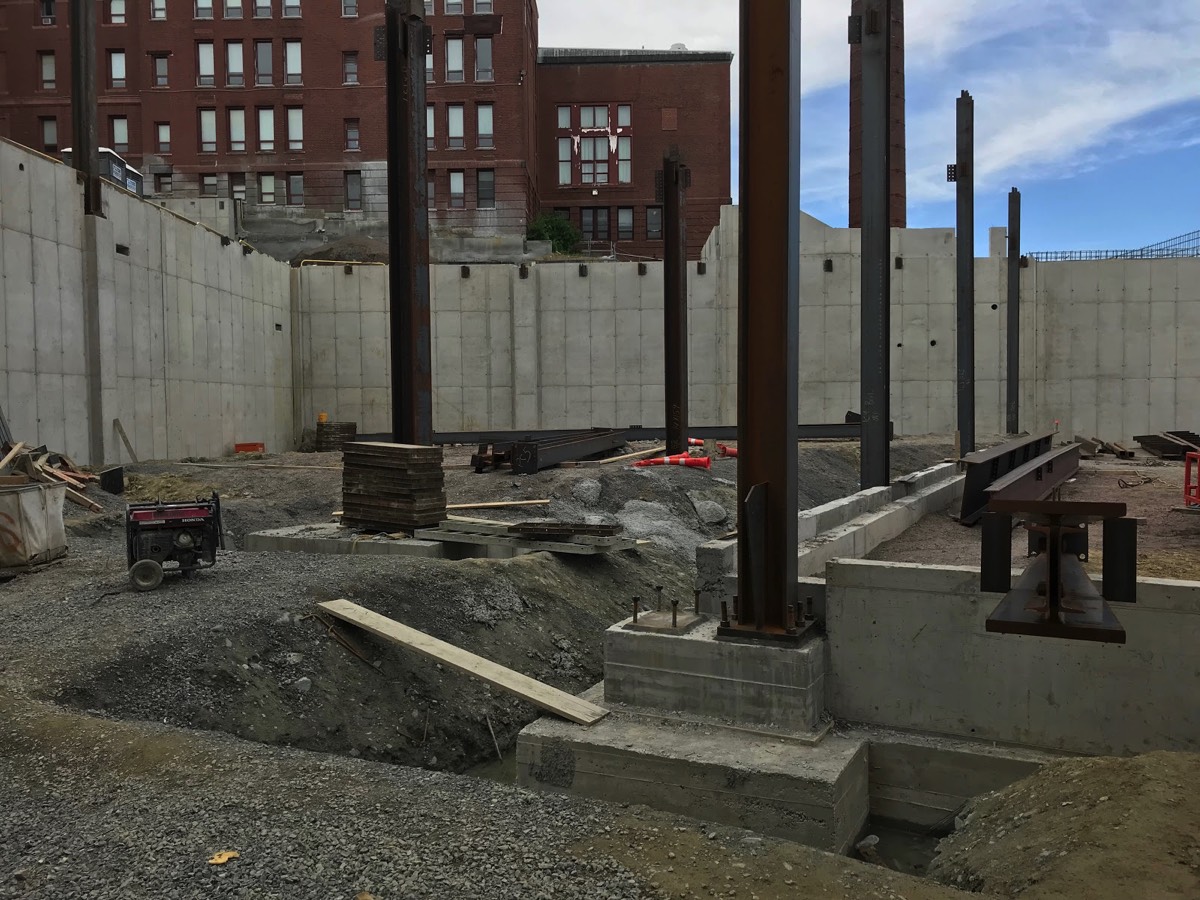

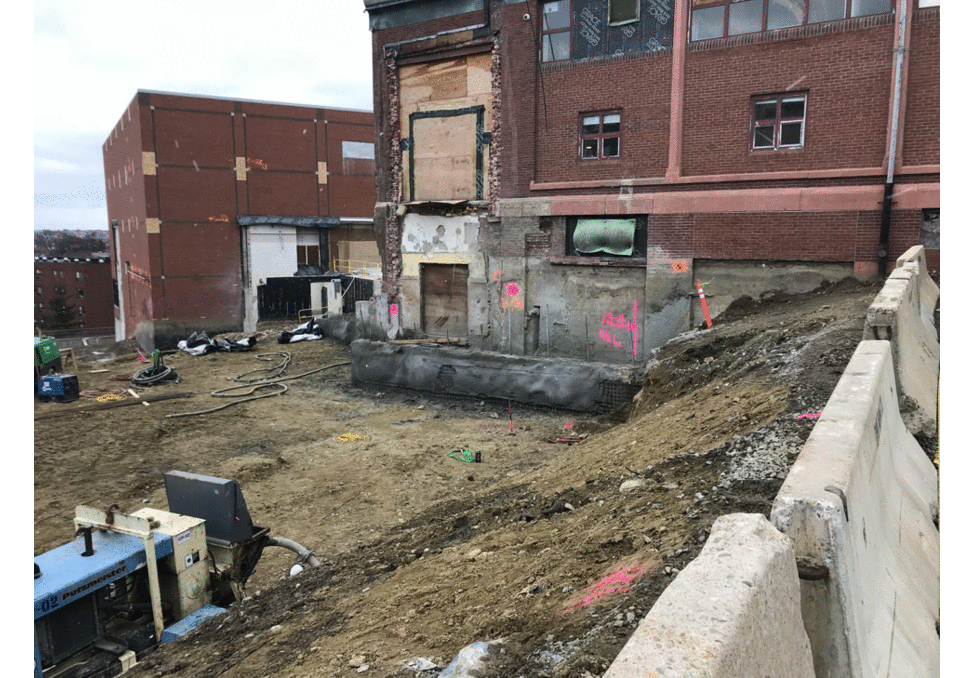

    Foundation Wall Construction

    Stacks Image 36440
  • February 2019

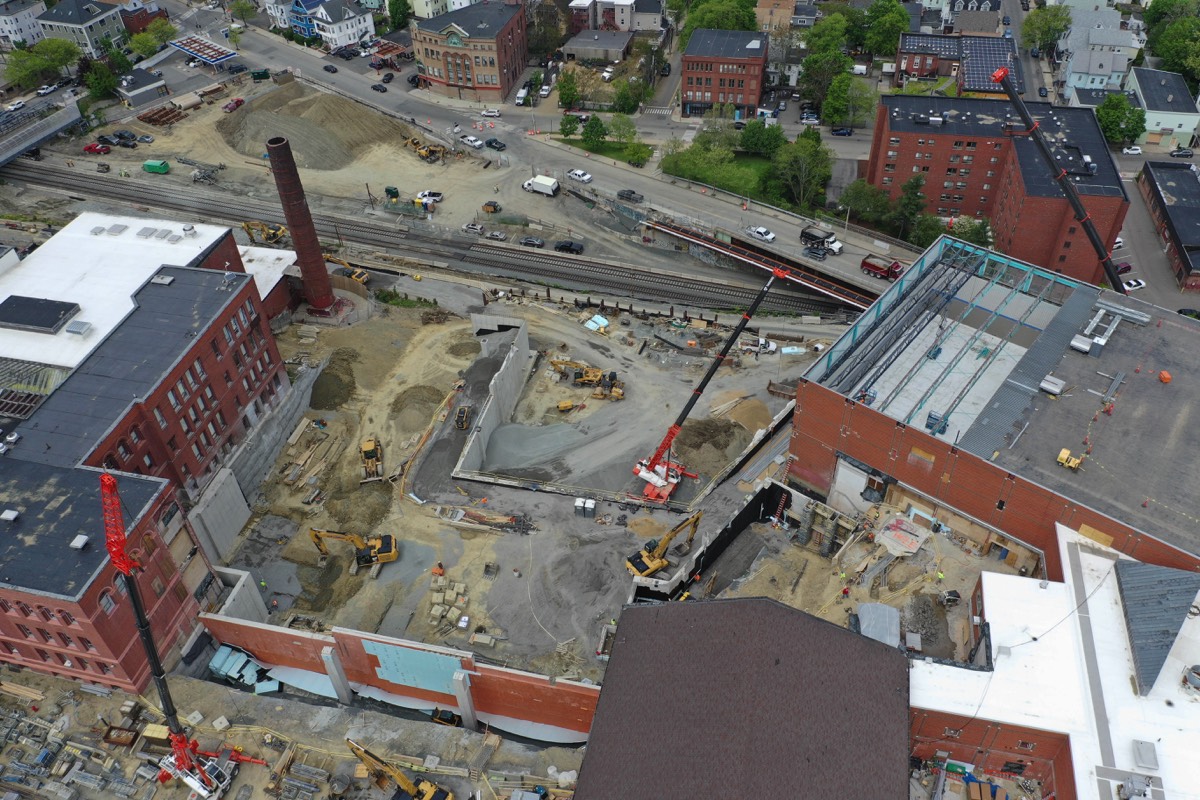

    Foundations Begin

  • January – February 2019

    Soil Nail Wall Installation

    Stacks Image 36436
  • November 2018 – February 2019

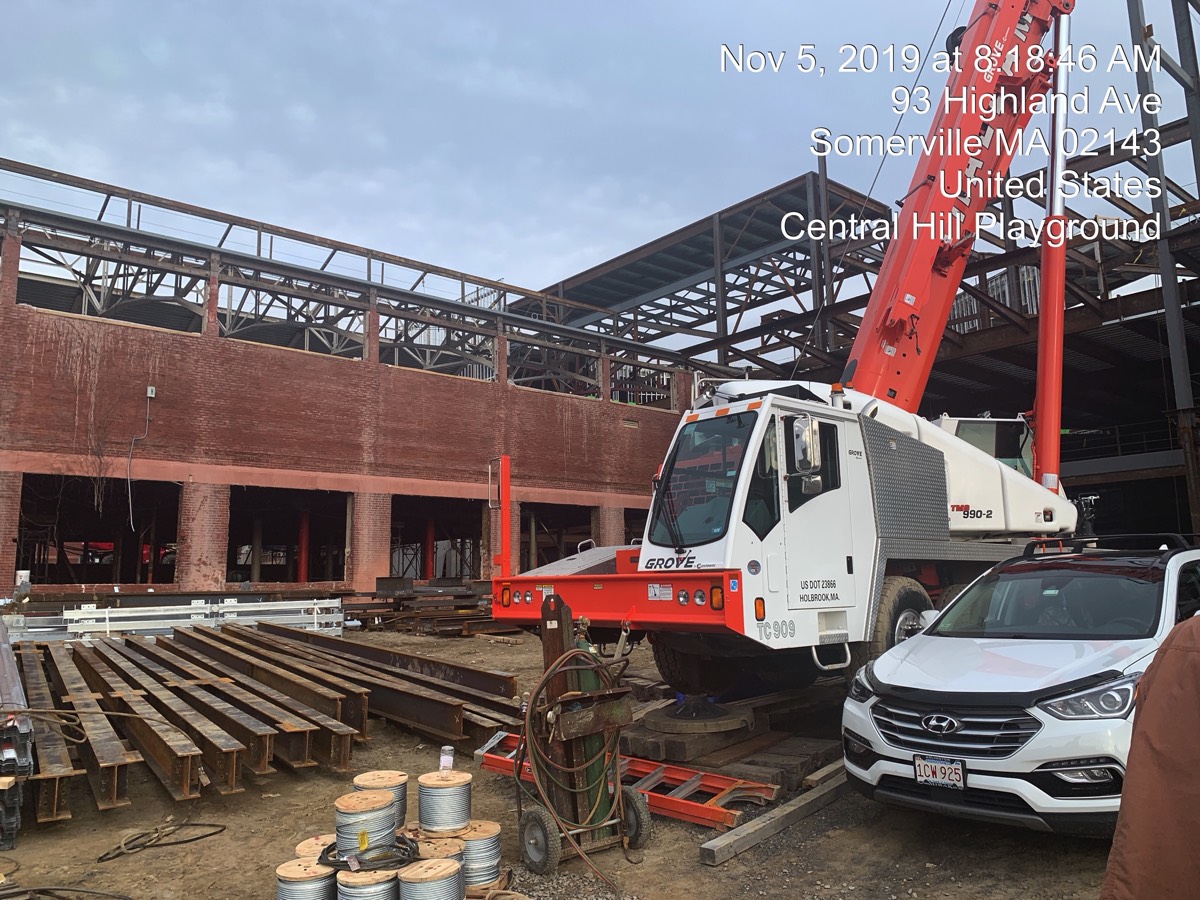

    Central Hill Monument Relocation

    Stacks Image 36434
  • October 2018 – February 2019

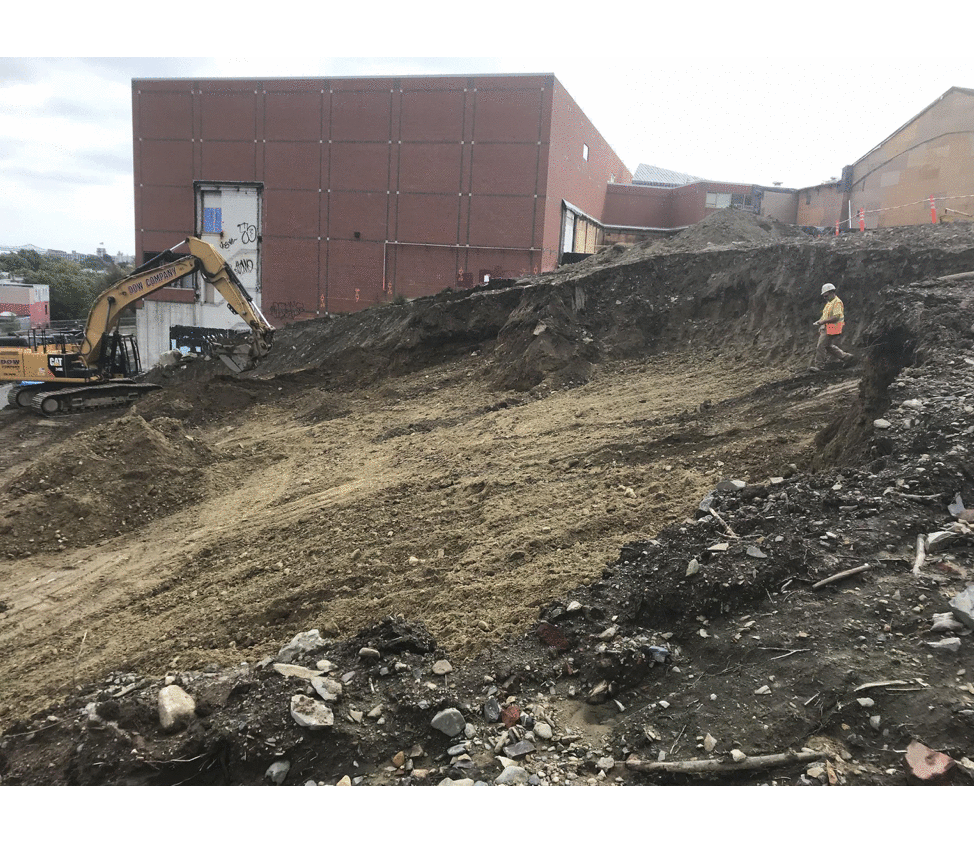

    Soil Excavation & Export

    Stacks Image 36432
  • September 2018

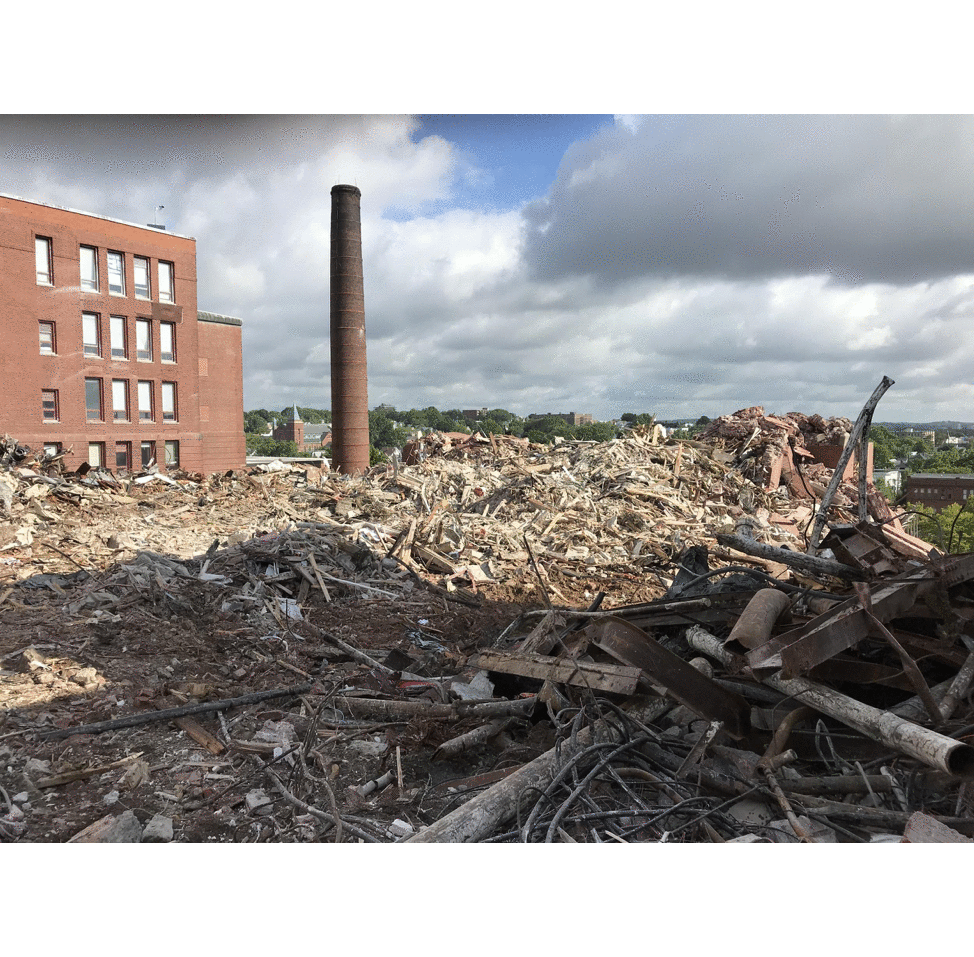

    Debris Removal

    Stacks Image 36430
  • June – August 2018

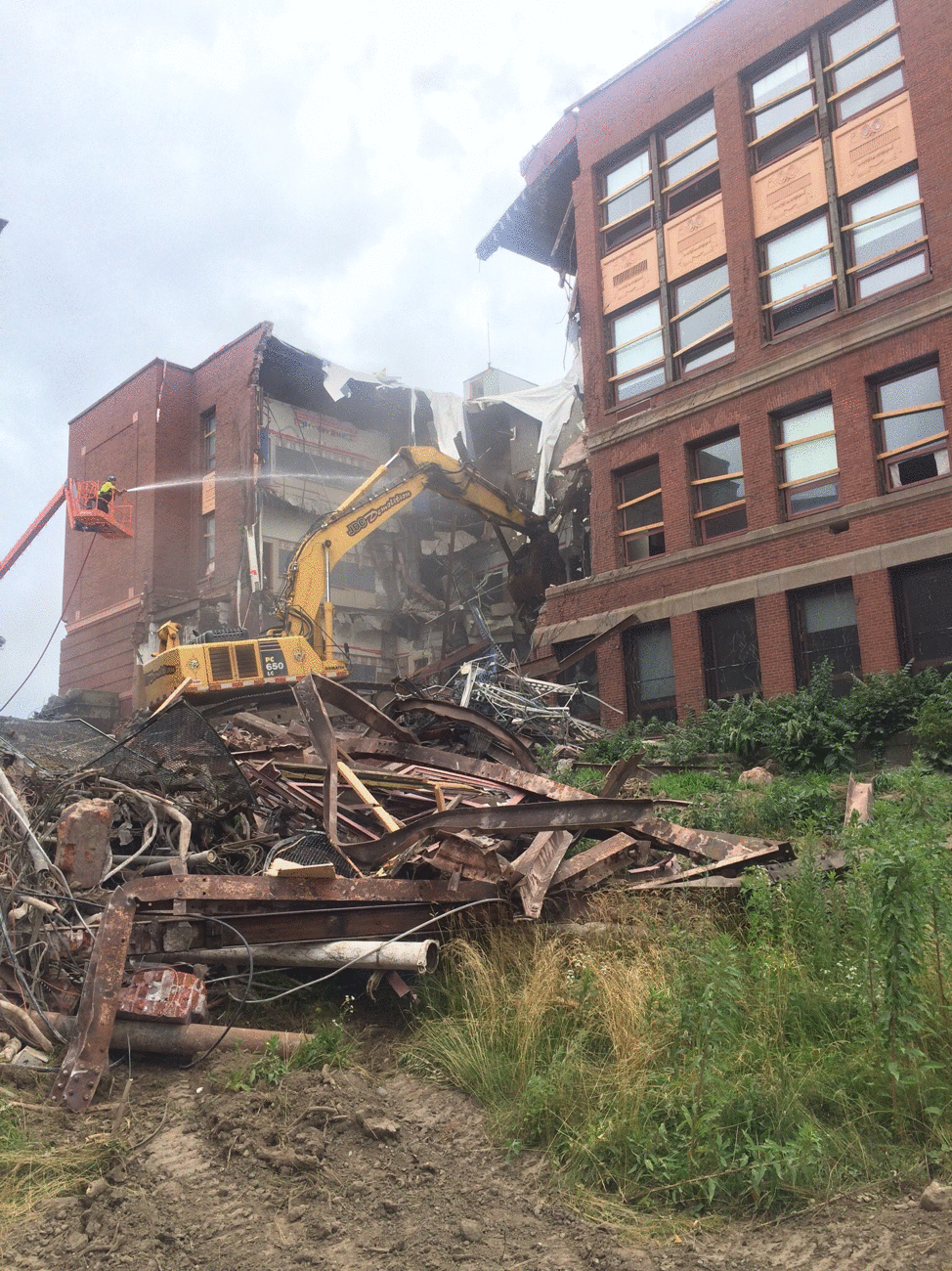

    East 1929 Classroom Wing Demolition & Abatement

    Stacks Image 36428
  • November 19 2014

    MSBA Review of Statement of Interest

  • November 20, 2014

    Invitation to MSBA Feasability

  • April 9 2015

    MSBA Approval of OPM

  • July 21, 2015

    MSBA DSP Interview Selection

  • July 31, 2015

    Project Team Formed

  • April 7, 2015

    PDP Submitted to MSBA

  • June 2, 2015

    Preferred Schematic Report (PSR) Submitted to MSBA

  • July 20, 2015

    MSBA Approval to Continue with PSR Given

  • January 4 2017

    Schematic Design Submitted to MSBA

  • February 15, 2017

    Schematic Design Approved by MSBA

  • July - August, 2017

    Modular Classroom Site Preparation

    Stacks Image 36246
  • August 11, 2017

    Design Development Submission

  • November 17, 2017

    60% Design Submission

  • December 2017

    Modular Classroom Delivery

    Stacks Image 36257
  • February 9 2018

    90% Design Submission

  • April 8, 2018

    100% Design Submission

  • April 2018

    East 1929 Classroom Wing Vacated, Students Move to Modulars

    Stacks Image 36268
  • June 2018

    New Building Phase 1 Construction Start

    Stacks Image 36276
  • June-August 2018

    East 1929 Classroom Wing Demolition & Abatement

  • Check back soon to learn about the next steps for the Somerville High School Building Project.

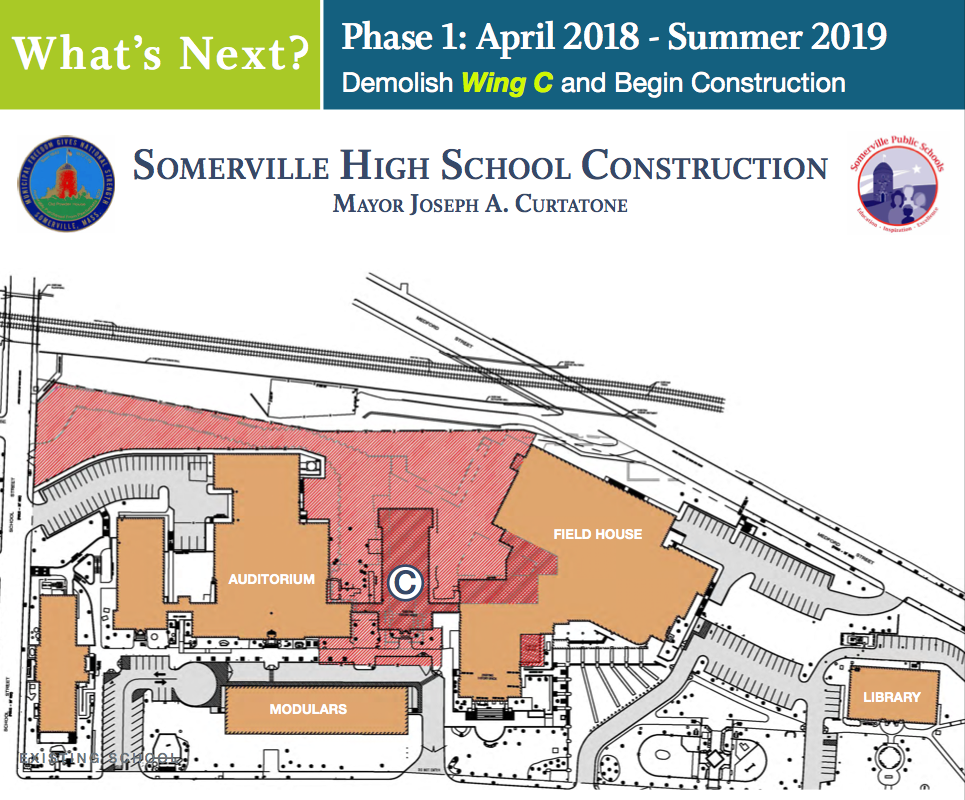

    April 2018-Summer 2019: Demolish Wing C and Begin Construction
